Lite Drag Box Installation Guide

How to assemble, install, drag and remove a Lite Drag Box, the lightweight drag box we hire and sell for continuous pipe-laying in stable ground.

The box is assembled flat on timber bearers, stood upright with a 4-leg chain and lowered into a trench dug beforehand in stable ground, then dragged along the trench by the excavator as the run progresses. Under the site conditions listed below, the maximum excavation depth is 3.9m. At the end of the run, you remove the box in lifts of no more than 500mm, backfilling inside it as you go.

If you'd like a printable copy, download the Lite Drag Box User Guide (PDF). For full specifications, see the Lite Drag Box product page.

Box Details

Box LengthPanel HeightBox Weight Range
2.00m2.0 Base776-827kg
2.00m1.0 Top406-420kg
2.50m2.0 Base894-945kg
2.50m1.0 Top462-476kg
3.00m2.0 Base1016-1077kg
3.00m1.0 Top518-532kg
3.50m2.0 Base1362-1413kg
3.50m1.0 Top582-596kg
4.00m2.0 Base1610-1661kg
4.00m1.0 Top844-858kg

Installation Sequence

1. Preparation

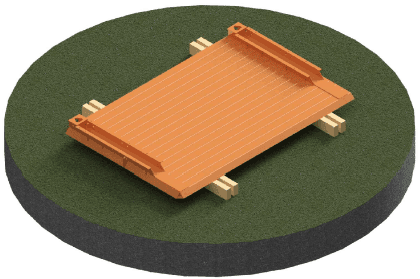

A Lite Drag Box panel laid flat on timber bearers

Lay Drag Box panel down on a level surface on suitable timber bearers using the 4-Leg chain provided.

Secure the lifting hooks through the handling points at the upper and lower ends of the channels.

2. Install spindles

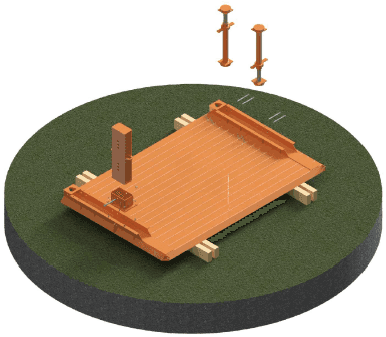

Adjustable spindles positioned in the channels of the Lite Drag Box panel

Spin out Spindles to the required length and position into the channels alternating as shown. Secure using Pins & R-Clips as shown in .

Secure the Collar using 4no M12x40 Bolts. Insert the correct length Distance Pipe and fix using an M20x200 Bolt.

3. Fit second panel

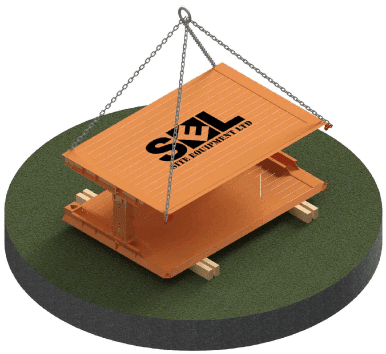

The second Lite Drag Box panel being lowered onto the spindles on a 4-leg chain

Lower opposite panel onto spindles using the 4-Leg chain. Chain hooks to be secured to the handling points at the upper and lower ends of each channel.

Secure to spindles as Stage 2. Do not remove slack in the chains until all the spindles are secured.

4. Stand box upright

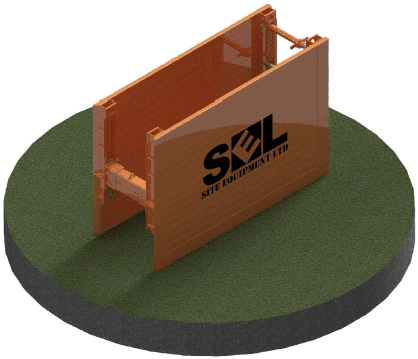

The assembled Lite Drag Box lifted into the upright position

Lift box into upright position using the 4-Leg chain secured through the upper handling points.

For narrow drag boxes, it is recommended to temporarily place the box into a shallow flat bottomed trench for stability.

5. Add top box

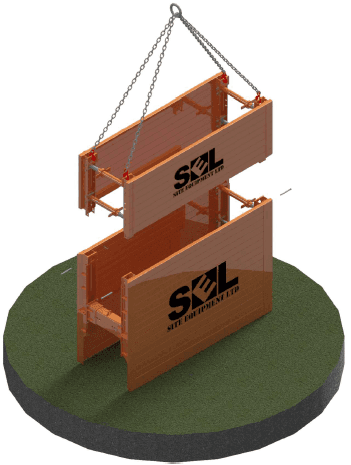

A Lite Drag Box top box being lowered onto the base box

Where required, lower Top Box onto Base Box (assembled similar to Stages 1-4).

Secure to Base box using Pins & R-Clips as shown in .

6. Lower into trench

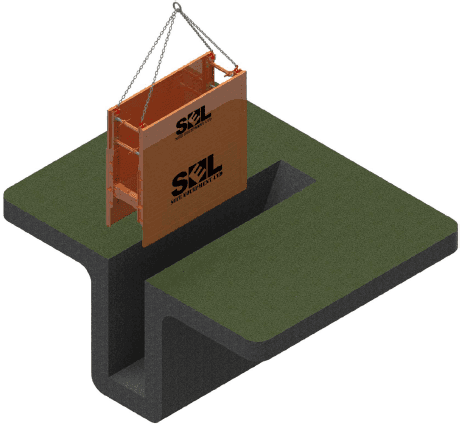

The Lite Drag Box being lowered into a pre-dug trench

Lift box into preformed trench excavated in stable ground. A competent person should assess the ground conditions, ensuring that the ground is temporarily stable and self supporting (see below).

A minimum 50mm upstand is recommended.

7. Drag the box

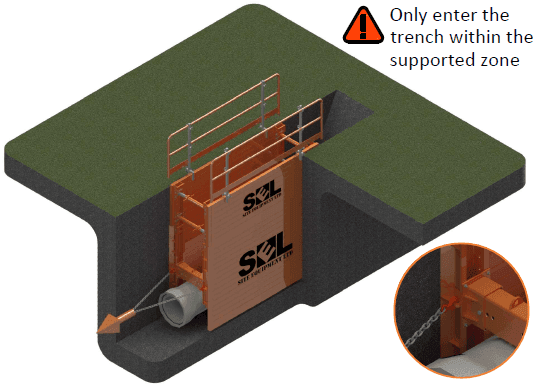

The Lite Drag Box being dragged along the trench by an excavator

Excavate the leading trench and drag the box using two chain legs fixed to the handling points on the cutting edge. Rather than tracking the machine, use the excavators hydraulic arm to drag the box.

Once the box is in the next location, adequately backfill the previous trench ensuring a safe batter slope remains.

Removal

The removal of the boxes should be performed sequentially. Once the end of the run is reached, the contractor should backfill inside the box in layers not exceeding 500mm.

Once the backfill is compacted to the Permanent Works design standard, the box can be lifted by a maximum of 500mm. If required, use a single chain leg to pull each corner of the box slightly before attempting to lift the whole box using the 4-Leg chain.

Repeat this process until the boxes can be removed completely.

Site Specific Considerations

A Trained and Competent person must assess both the site and ground conditions.

The box is intended to be employed in ground which is stable and self supporting in the short term whilst installing the boxes to the final depth.

If any of the following ground conditions are anticipated / encountered, please contact SEL for advice as this box system may not be suitable.

  • Unknown Ground
  • Very Soft CLAY
  • Very Loose SAND
  • Silt
  • Very Loose Gravel
  • Peat

Careful consideration must be given to employing boxes in water bearing soils or in the vicinity of watercourses.

If anything beyond the following site conditions are anticipated / encountered please contact SEL for advice.

  • Maximum excavation depth of 3.9m
  • Maximum excavation duration <12 weeks
  • Plant and machinery <30T operating near dig.
  • No Structures located within 4m of dig.
  • Adjacent slopes not in excess of +/- 1 in 10.
  • No Services cross the path of the boxes.
  • Deflection sensitive services not located within 4m of the dig.
  • A live railway is not located within 7m of the edge of the excavation.
  • Public Highway not located within 7m of the edge of the excavation.
  • Suitable plant is available to lift and manoeuvre the selected box.

Residual Risks

The following residual risks must be addressed in the Contractors RAMS:

  1. When lowering the opposite panel onto the spindles, ensure operatives hands are low down on the spindle (Stage 3).
  2. Ensure operatives hands are kept clear of pinch points when lowering the top box onto the base box (Stage 5).
  3. When removing the chains from the opposite panel, consider potential working at height risks (Stage 3).
  4. Locate all potential services prior to excavation in accordance with NRSWA Regulations.
  5. The excavation may be classified as a confined space. The Contractor must assess this risk and provide suitable gas detection and rescue equipment where appropriate.
  6. If a spindle is struck accidentally by an excavator, inspect immediately. If damage is visible, remove the box from the trench and replace the spindle following the steps identified above.

Do's and Don'ts

  • Contact Site Equipment if unsure about any element of this document.
  • Inspect all components to ensure that there are no signs of damage and that they are installed correctly.
  • Ensure that the limitations of the box and this safe use guide is fully briefed to all operatives undertaking the work.
  • Ensure suitable edge protection and access are provided as required.
  • Ensure suitable lifting equipment is employed and suitable checks are carried out regularly.
  • Ensure that the full height of adjacent soil is considered where a local ground reduction has been undertaken.
  • Do not enter an excavation unless it has appropriate shoring in place.
  • Do not have vertical earth faces at ends of boxes (see end closure options).
  • Do not allow overdigging of the excavation.
  • Do not allow storing of spoil or construction materials within 4m of the proposed excavation.
  • Do not fly the boxes.
  • Do not have out of balance digs.

End Closure Panels

If required, drag boxes can be closed off using suitable end closures (End Closure Panels or suitably supported sheets).

Do not use the spindles for support.

Please contact SEL for further information on our full range of end closure options.

Edge Protection & Access

Please contact Site Equipment for info on our full range of Access & Edge Protection accessories.
