Standard Trench Box Installation Guide
This is a step-by-step safe use guide covering how to assemble, position and then extract the Standard Trench Box, SEL's heavy-duty steel shoring system for deep drainage, sewer, and utility excavations. Once assembled, the box should be lowered into a starter trench up to 1.25m deep using an excavator or crane and a 4-leg chain sling, then progressively dug and pushed down to depths of up to 5.3m.
Key Considerations
- Required Plant & Lifting Equipment
- Excavator or crane (<30T) · 4-leg chain sling
- Component Weights
- 1,680–3,486kg (base) · 990–2,058kg (top)
- Working Limits
- 5.3m max trench depth · ±8° max spindle rotation
- Site Conditions
- 5.3m from structures · 4m from sensitive services · 7m from roads/rail
Installation Sequence

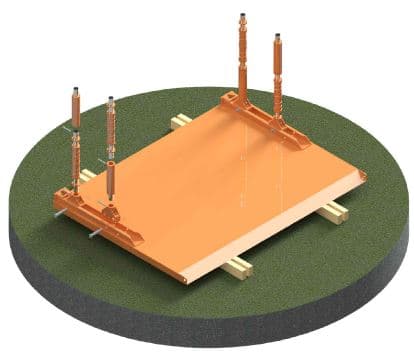

Step 1: Lay Out the First Panel and Connect the Spindles

Using an excavator or crane and a 4-leg chain sling hooked through the four handling points at the ends of the vertical channels, lift the first Standard Trench Box panel and lay it flat on timber bearers on level ground with the channels facing upwards.
Pin the four Spring Spindle Holders into the channels using 1no 40Ø Pin & R-Clip per holder, then connect the Adjustable Spindles and required extension pipes to the holders using 20Ø Pins & R-Clips (see a ).
Ensure that the two lower spindles are extended by 30–50mm more than the two top spindles.

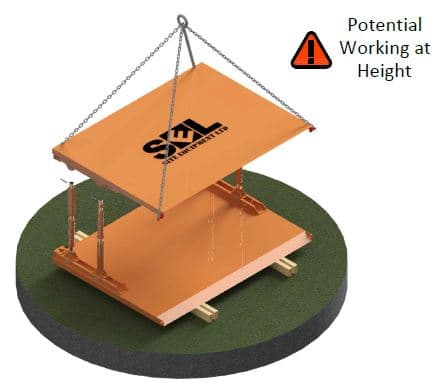

Step 2: Lower and Pin the Opposite Panel

Fit the four Spring Spindle Holders into the opposite panel's channels using 1no 40Ø Pin & R-Clip per holder, then attach the 4-leg chain sling hooks to the four handling points at the upper and lower ends of each side. Using the excavator or crane, lift the opposite panel (channels facing downwards) and lower it onto the four upright spindles.
Secure the spindles into the upper panel's Spring Spindle Holders using 20Ø Pins & R-Clips (see a ). Keep the chain sling under tension until all four spindles are fully pinned and clipped.
Safety check: Keep operatives' hands low down on the spindles when guiding the opposite panel onto them, and account for working-at-height risks when unhooking the lifting chains from the upper panel.

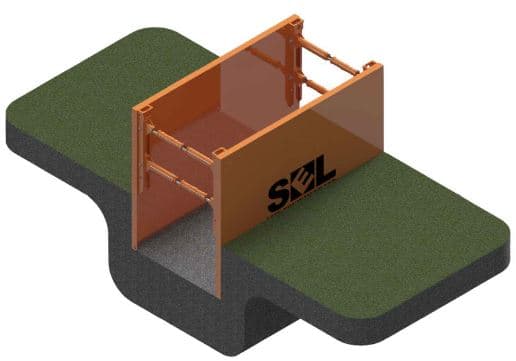

Step 3: Stand the Box Upright and Lower into the Starter Trench

Attach the 4-leg chain sling hooks to the four upper handling points at the top of the channels, lift the assembled box into an upright position using the excavator or crane, and lower it into a pre-excavated starter trench no deeper than 1.25m (with soil stability assessed beforehand by the Contractor).
Backfill and compact any voids between the outside of the box panels and the starter trench walls so the box is held upright and supported before digging deeper.

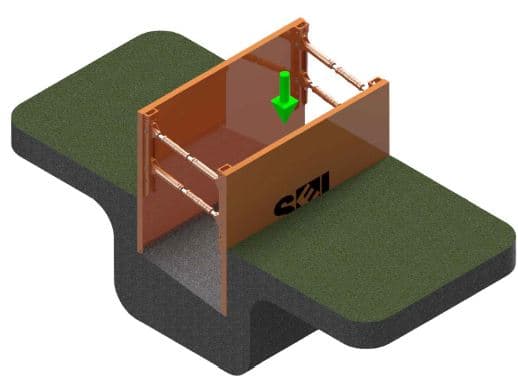

Step 4: Excavate Inside and Push the First Panel Down

Excavate inside the box up to 500mm deeper beneath the cutting edges, then use the underside of the excavator bucket to push the top edge of one panel smoothly downwards.
Do not strike or batter the box with the bucket, and never push on the spindles. Ensure spindle deflection does not exceed ±8° rotation at any point, and do not allow anyone to enter the trench until the box is fully installed.

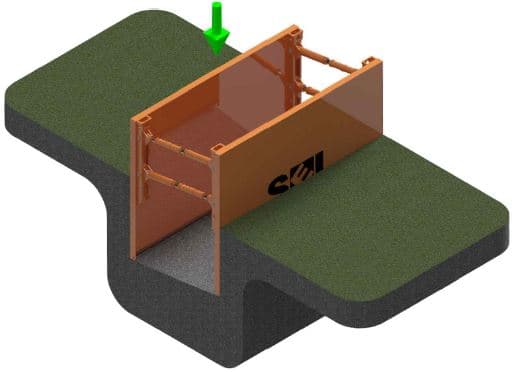

Step 5: Push the Opposite Panel and Repeat to Depth

Push the top of the opposite panel down to match, then continue alternating excavation and pushing on each side to work the box down to the required formation depth.
Smaller incremental dig-and-push steps reduce stress on the panels and spring spindle holders.

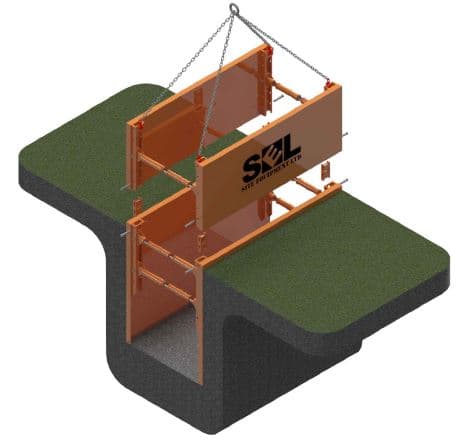

Step 6: Attach the Top Box (Where Required)

Where a Top Box is required for deeper excavations, pre-assemble the Top Box flat on timber bearers following Steps 1–2 and lift it upright using the excavator or crane and a 4-leg chain sling. Lower the Top Box onto the installed Base Box and lock all four corners together using a Box Connection Unit and 2no 40Ø Pins & R-Clips per corner (see a ).
Continue the alternating dig-and-push sequence as before until the full excavation depth is reached.
Safety check: Keep operatives' hands clear of pinch points between the panels and vertical channels while lowering the Top Box onto the Base Box.

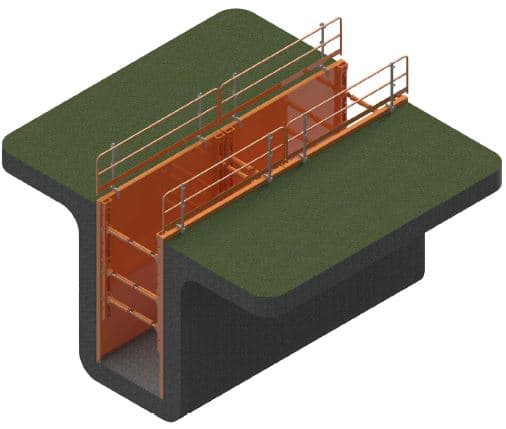

Step 7: Fit Edge Protection and Close Open Ends

Fit suitable perimeter edge protection barriers and safe ladder access to the installed box where required. Ensure that the open ends of the excavation are either battered back to a safe angle determined by the Contractor or closed off using compatible end closure panels or supported trench sheets (see Installing with Additional Equipment).
Removal Instructions
Step 1: Backfill and Compact in 500mm Layers
Extract the Standard Trench Box sequentially once the permanent works are installed. Backfill inside the box in layers no deeper than 500mm and compact each layer to the Permanent Works design standard before lifting the box.
Step 2: Lift in Maximum 500mm Stages
Using the excavator or crane and a 4-leg chain sling attached to the upper handling points, lift the box by a maximum of 500mm per compacted layer without exceeding ±8° spindle rotation between the opposite panels.
Step 3: Remove Top Boxes and Complete Extraction
Continue backfilling, compacting, and lifting sequentially in the reverse of the installation procedure, unpinning and removing any Top Boxes as they clear the trench, until the Base Box is completely removed.
Site-Specific Considerations
A Trained and Competent person must assess both the site and ground conditions.
The boxes must be installed using the Dig & Push method in temporarily unstable ground. In stable and self supporting ground the boxes can simply be lifted into a pre-excavated trench. If any of the following ground conditions are anticipated / encountered, please contact SEL for advice as this box system may be limited in depth or suitability.
- Unknown Ground
- Soft / Very Soft CLAY
- Very Loose SAND
- Silt
- Very Loose GRAVEL
- Peat
Careful consideration must be given to employing boxes in water bearing soils or in the vicinity of watercourses.
If anything beyond the following site conditions are anticipated / encountered please contact SEL for advice.
- Maximum excavation depth of 5.3m
- Maximum excavation duration <12 weeks
- Plant and machinery <30T operating near dig.
- No Structures located within 5.3m of dig.
- Adjacent slopes not in excess of +/- 1 in 10.
- No Services cross the path of the boxes.
- Deflection sensitive services not located within 4.0m of the dig.
- A live railway is not located within 7m of the edge of the excavation.
- Public Highway not located within 7m of the edge of the excavation.
- Suitable plant is available to lift and manoeuvre the selected box.
Residual Risks
The following residual risks must be addressed in the Contractors RAMS:
- When lowering the opposite panel onto the spindles, ensure operatives hands are low down on the spindle (Stage 2).
- Ensure operatives hands are kept clear of pinch points when lowering the top box onto the base box (Stage 6).
- When removing the chains from the opposite panel, consider potential working at height risks (Stage 2).
- Locate all potential services prior to excavation in accordance with NRSWA Regulations.
- The excavation may be classified as a confined space. The Contractor must assess this risk and provide suitable gas detection and rescue equipment where appropriate.
- If a spindle is struck accidentally by an excavator, inspect immediately. If damage is visible, remove the box from the trench and replace the spindle following the steps identified above.
Safe Usage Checklist
- Contact Site Equipment if unsure about any element of this document.
- Inspect all components to ensure that there are no signs of damage and that they are installed correctly.
- Ensure that the limitations of the box and this safe use guide is fully briefed to all operatives undertaking the work.
- Ensure suitable edge protection and access are provided as required.
- Ensure suitable lifting equipment is employed and suitable checks are carried out regularly.
- Ensure that the full height of adjacent soil is considered where a local ground reduction has been undertaken.
- Do not enter an excavation unless it has appropriate shoring in place.
- Do not have vertical earth faces at ends of boxes (see end closure options).
- Do not allow overdigging of the excavation.
- Do not allow storing of spoil or construction materials within 4m of the proposed excavation.
- Do not fly the boxes.
- Do not have out of balance digs.
Installing with Additional Equipment
Both ends of the boxes must be either connected to an adjacent box, suitably battered back, or closed off using suitable end closures (End Closure Panels or suitably supported sheets).
Do not use the spindles for support.
Please contact SEL for further information on our full range of end closure options and Access & Edge Protection accessories.
